ArticlesGlobal Mega Projects

Brenner Base Tunnel: 9 Extraordinary Engineering Achievements Powering Europe’s Deepest Alpine Crossing

Brenner Base Tunnel: 9 Extraordinary Engineering Achievements Powering Europe’s Deepest Alpine Crossing


The Brenner Base Tunnel (Brenner Base Tunnel) is a twin-tube rail tunnel being bored 580 metres below the Brenner Pass, connecting Innsbruck, Austria, with Fortezza, Italy, across 55 kilometres of Alpine rock. When it opens in 2032, the full system, including the existing Innsbruck bypass, will extend 64 kilometres, surpassing the Gotthard Base Tunnel as the world’s longest railway tunnel. With a total project cost of approximately €10.5 billion and over 230 kilometres of tunnels across the wider system, the Brenner Base Tunnel is the most technically complex deep Alpine rail project under construction in Europe.

Technical Snapshot: Brenner  Base Tunnel Specifications

Project Name: Brenner Base Tunnel (Brenner Base Tunnel)
Location: Innsbruck, Austria, to Fortezza, Italy
Total Tunnel Length: 55 km (64 km including Innsbruck bypass)
Total Tunnel System: 230+ km across all tunnels
Main Tube Diameter: 8.1 m per tube (twin single-track)
Tube Spacing: 40–70 m apart
Max Overburden: 1,720 m below surface
Depth Below Brenner Pass: 580 m
Estimated Cost: €10.5 billion
EU Contribution: €2.3 billion (CEF Transport programme)
Scheduled Opening: 2032
Client: Brenner Base Tunnel SE (Austria-Italy joint entity)
Key Contractors: Webuild, Implenia, STRABAG, Integra Consortium

The Brenner Base Tunnel is the critical bottleneck fix on the Scandinavian-Mediterranean TEN-T Corridor, a route designed to link Helsinki to La Valletta by rail. No other infrastructure project in Alpine Europe carries greater strategic weight for the continent’s freight decarbonisation agenda.


Introduction: The Problem the Brenner Base Tunnel Is Built to Solve

The existing Brenner railway opened in 1860. It climbs to 1,371 metres above sea level with gradients of up to 26 per cent, severe enough to demand two locomotives on the Italian approach and three on the Austrian side. The line cannot compete with road freight on speed, load capacity, or cost. The result is structural: more than 2.5 million heavy goods trucks and 50 million tonnes of freight cross the Brenner Pass by road every year, making it the busiest Alpine freight crossing in Europe.

The Brenner Base Tunnel addresses this by replacing a 19th-century mountain railway with a nearly flat, high-speed underground route. Gradients inside the tunnel run at 4 to 7 per cent. Passenger trains will operate at up to 250 km/h, reducing the Innsbruck-Fortezza journey from 80 minutes to 25 minutes. Freight trains will run heavier, faster, and more frequently, with the realistic prospect of moving a significant share of current road freight onto rail. Engineers describe the tunnel not as a transport upgrade but as a continental-scale shift in modal choice.

This article examines nine engineering achievements that define the Brenner Base Tunnel’s construction, from its geological reconnaissance strategy to its liquid nitrogen ground-freezing technique, and explains why each one matters for the project’s completion in 2032. For a broader view of how the Brenner Base Tunnel fits within Europe’s most consequential infrastructure pipeline, the bridge and tunnel megaprojects overview provides strategic context across nine comparable engineering feats.

Engineering Achievement 1: The Exploratory Tunnel as a Live Geological Instrument

The Brenner Base Tunnel’s most consequential design decision was not about the main tunnels. It was the choice to bore a third tunnel, 12 metres below and between the two main tubes, before the primary excavation began. This exploratory tunnel, 5 to 8 metres in diameter and running the full 56-kilometre cross-border length, served as a continuous geological investigation tool, providing rock mass data, fault zone mapping, and groundwater pressure measurements that directly shaped the main tunnel’s executive design.

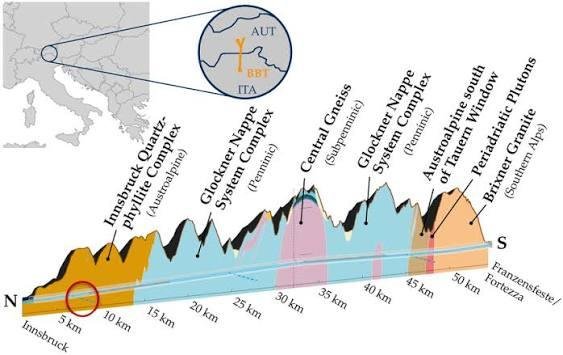

Geology of the Brenner Base Tunnel (BBT) from Innsbruck (left) to Fortezza (right).
Geology of the Brenner Base Tunnel (BBT) from Innsbruck (left) to Fortezza (right). (Source: ResearchGate)

Pre-Excavation Intelligence That Reduced Geological Risk

Exploratory tunnelling started in December 2007. On 18 September 2025, workers achieved the first cross-border breakthrough, physically connecting the Austrian and Italian sections underground after 18 years of intermittent excavation through some of the most complex rock formations in the Alps. The deviation across the full 29-kilometre Austrian drive measured in the single-digit centimetre range, a surveying precision that allowed the main tunnel bores to proceed without costly alignment corrections.

The intelligence gathered along the exploratory bore changed the main tunnel design in measurable ways. Fault zones identified by the advanced drives allowed contractors to pre-position consolidation equipment, adjust TBM shield configurations, and revise lining specifications before the large-diameter machines arrived. By the time 88 per cent of total excavation was complete in August 2025, the project had avoided several potential stoppages that would have been discovered cold without the pilot bore data.

Once the railway opens, the exploratory tunnel shifts function entirely, becoming a drainage channel, maintenance corridor, and technical installation route. No space is wasted. The same bore that de-risked construction becomes a permanent operational asset.

Engineering Achievement 2: Operating Inside Extreme Alpine Geology

The Brenner Base Tunnel passes through geological formations that span hundreds of millions of years of tectonic history. The rock column along the alignment includes granite, gneiss, marble, schist, Innsbruck quartzphyllite, and Bundner slates containing dolomites, quartzites, and anhydrites. Overlaid on this lithological complexity is the Periadriatic Fault, one of the most significant tectonic boundaries in the Alpine chain, formed by the collision of the African and Eurasian plates.

The Periadriatic Fault and Fault Zone Management

At approximately 47 to 48 kilometres from Innsbruck, the alignment crosses the Periadriatic Line near Fortezza. This regional fault zone presented the single largest geological risk on the Italian section. Rock strength along the alignment reaches up to 250 MPa in places, while fault zones collapse into fractured, unstable ground. The two conditions, extreme hardness and sudden structural collapse, can occur within metres of each other.

During exploratory tunnel construction, crews 900 metres below the surface encountered a massive quartz-schist fault zone, causing active caving around the TBM. Engineers stabilised the tunnel face using tube-a-manchette consolidation: fibreglass pipes drilled ahead of the face with cement injections filling voids and binding fractured material. At a depth of 1,600 metres, a squeezing phenomenon, where the mountain pressure closes the tunnel profile faster than the machine can advance, forced crews to cut tunnel lining segments manually and switch to drill-and-blast to free the trapped TBM. These were not edge cases. They defined the standard operating environment for deep Alpine excavation on this project.

The H41 Sill Gorge-Pfons lot on the Austrian side presented similar conditions. TBM Ida, a 160-metre, 2,420-tonne Herrenknecht double-shield machine with a 10.4-metre cutter head, completed its 8,400-metre drive in August 2025, crossing two major fault zones, named Viggartal and Walzn, and then the Werner fault zone below the Arztal valley in Pfons. Each fault crossing required speed reduction and advance consolidation before the machine could safely continue.

Engineering Achievement 3: A Fleet of Herrenknecht TBMs Engineered for the Specific Rock

Not all tunnel boring machines can operate in deep Alpine conditions. The Brenner Base Tunnel team, working with Herrenknecht, specified machines designed from the ground up for this project’s geological profile: high rock strength, aggressive water inflows, squeezing ground, and thermal gradients from geothermal heat at depth. Four Herrenknecht TBMs drive the major mechanised sections of the Brenner Base Tunnel, with a split approach in which TBMs handle the main bore sections, while conventional methods handle fault zones and access tunnels.

Double-Shield TBMs and the 50/50 Excavation Split

The Italian section’s main tunnels at the Mules 2-3 lot use two double-shield TBMs with cutter head diameters of 10.71 metres. Double-shield machines are selected for their ability to operate simultaneously in two modes: gripper mode for stable hard rock, where the outer shield anchors against the tunnel wall to push forward, and shield mode for weaker zones, where the rear shield provides structural protection while the cutter advances. This flexibility is not optional in heterogeneous Alpine geology. It is the condition for continuous advance.

Across the full project, approximately 50 per cent of the total excavation is mechanised (TBM) and 50 per cent conventional. The conventional work uses two primary methods: drill-and-blast in stable rock zones where TBM deployment is not cost-effective, and the New Austrian Tunnelling Method (NATM) in weaker ground. NATM installs shotcrete linings and rock bolts immediately as excavation progresses, allowing the surrounding rock mass to take the load before the permanent lining is cast. The Tulfes-Pfons lot, at more than 42 kilometres of tunnels, used 15 kilometres of TBM excavation and 27 kilometres of NATM, a ratio that reflects the complexity of the northern Austrian section’s geology.

Engineering Achievement 4: Ground Freezing Under the Isarco River

The southernmost construction lot of the Brenner Base Tunnel, Lot H71, posed a different engineering challenge. At Fortezza, the tunnel alignment must underpass the Isarco River, the A22 Brenner motorway, the SS12 national road, and the existing Verona-Brenner railway line, all within a corridor offering minimal vertical clearance. The combined loading above the tunnel, the presence of a live watercourse, and the saturated alluvial ground made conventional excavation impossible without either diverting the river or risking settlement damage to the road and rail infrastructure above.

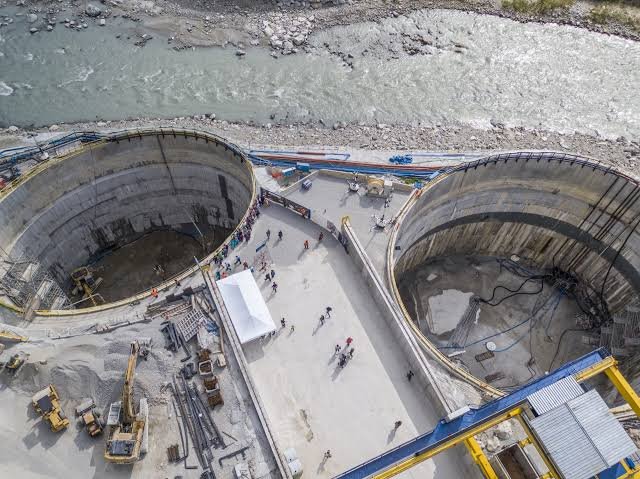

Brenner Base Tunnel tunnel alignment underpasses the Isarco River.
The Brenner Base Tunnel alignment includes underpasses under the Isarco River. (Source: WE Build Value)

Liquid Nitrogen Ground Freezing: Zero River Diversion

The design solution was ground freezing using liquid nitrogen. The Webuild-led joint venture drilled freeze pipes into the ground around the tunnel perimeter and circulated liquid nitrogen at temperatures below -196 degrees Celsius. The saturated soil and alluvial material around the tunnel face froze into a structural shell, providing both water exclusion and temporary ground support without disrupting the surface of the Isarco River.

Construction started from four wells, approximately 30 metres deep. The four tunnels, two main bores and two interconnection tunnels linking to the existing Brenner line, were excavated sequentially through the frozen ground. The 4.5 kilometres of main tunnels and 1.7 kilometres of interconnecting tunnels in this lot were completed and handed over in December 2023. The technique eliminated any need to divert a protected alpine watercourse, a significant environmental constraint in the sensitive Brenner region.

For comparison, the engineering complexity of building under active waterways appears across Europe’s major infrastructure projects. The Fehmarnbelt Tunnel takes a fundamentally different approach under the Baltic Sea, using prefabricated immersed tube elements. The Brenner Base Tunnel’s ground-freezing method reflects the difference between alluvial river conditions and open marine excavation. Both are technically sound; neither is transferable to the other’s environment without fundamental redesign.

Engineering Achievement 5: The Three-Tube System and Emergency Architecture

The Brenner Base Tunnel is not simply two main tunnels. The full system integrates three parallel tubes, cross-passages, multifunction stations, and access tunnels into a safety architecture designed around the specific risks of fire and evacuation in a 55-kilometre underground environment. Every design decision in this section is driven by the same question: how do you evacuate people from a fire 25 kilometres from the nearest portal in a tunnel carrying trains at 250 km/h?

Brenner Base Tunnel 3-tube tunnelling system.
Brenner Base Tunnel 3-tube tunnelling system. (Source: Geodata)

Cross-Passages Every 333 Metres and Three Emergency Stations

The two main single-track tubes are spaced 40 to 70 metres apart and connected by cross-passages at 333-metre intervals. In a fire event, passengers evacuate through the nearest cross-passage into the smoke-free opposite tube. The opposite tube serves as both an evacuation route and a rescue access corridor for emergency services entering from either portal or from one of the three multifunction stations located at Trens (Freienfeld), St Jodok, and a third intermediate point, each approximately 20 kilometres apart.

The exploratory tunnel, 12 metres below the main bores, adds a third evacuation layer. In a scenario where both main tubes are compromised, the lower gallery provides a separate safe zone accessible via vertical shafts from the main tunnels. The integrated ventilation system manages smoke in cross-section: in a fire event, airflow in the affected tube is controlled to push combustion gases away from passengers towards the nearest portal, while the opposite tube maintains positive pressure to keep smoke from migrating through the cross-passages.

The safety framework draws on lessons from previous long Alpine rail tunnels, including the Gotthard Base Tunnel in Switzerland, which opened in 2016 and held the world record for longest rail tunnel until the Brenner Base Tunnel’s completion. It also reflects the improvements European railway safety authorities demanded following tunnel fire incidents in road tunnels during the 1990s. The Channel Tunnel’s fire safety engineering established the benchmark for separated-tube evacuation systems that all subsequent European rail tunnels have followed.

Further Reading: Channel Tunnel: 10 Proven Engineering Breakthroughs Behind the World’s Most Iconic Cross-Border Link

Engineering Achievement 6: Managing 1,720 Metres of Rock Overburden

The Brenner Base Tunnel’s maximum overburden, at 1,720 metres below the surface, places it among the deepest railway tunnels ever constructed. At that depth, rock temperature, hydrostatic water pressure and in-situ stress combine to create conditions that defeat standard TBM configurations. The project’s approach to deep-cover engineering involves continuous real-time monitoring, adaptive support systems, and machine configurations specifically rated for the expected stress environment.

Rock Temperatures, Water Pressure, and Structural Response

Geothermal gradients in the Eastern Alps produce rock temperatures of approximately 40°C at a depth of 1,700 metres. TBM components, lubricants, and onboard electronics must operate reliably in this environment. The tunnels cross groundwater pressures that have reached 27 bar in documented fault zones, high enough to deform tunnel lining segments if the consolidation grouting is inadequate. Engineers on the Italian section used polymer injection during one such event to stabilise the lining before water pressure compromised the ring geometry.

Monitoring systems deployed along the tunnel include geotechnical sensors embedded in the lining segments, extensometers tracking radial rock movement, and piezometers logging groundwater pressure. The data feeds into real-time dashboards that allow engineers to identify convergence trends before they reach critical levels. NATM’s foundational principle, allowing controlled deformation while maintaining structural integrity, depends entirely on the quality of this monitoring data.

The Brenner Base Tunnel has applied that principle in greater depth and over a longer period than any previous NATM project in Europe. A 2014 geotechnical analysis of the Brenner Base Tunnel exploratory tunnel, published in Engineering Geology, documented how brittle fault zones parallel to the tunnel axis caused lining collapses more than two diameters behind the face, a failure mode that the main bore monitoring programme is specifically designed to detect early.

Engineering Achievement 7: A Binational Project Governance Model That Actually Functions

The Brenner Base Tunnel is owned and managed by Brenner Base Tunnel SE, a binational company incorporated as a Societas Europaea under European law, with Austria’s ÖBB holding 50 percent and Italy’s TFB holding the remaining 50 percent. The governance structure provides both countries with equal board representation and equal financial obligations, with the EU contributing up to 50 percent of the main tunnel costs through the Connecting Europe Facility Transport (CEF-T) programme. In practice, this means that every major procurement, design revision, and construction contract must simultaneously satisfy two national regulatory regimes, two sets of railway safety authorities, and EU funding reporting requirements.

Coordinating Across Borders, Languages, and Regulatory Systems

The construction lots straddle the national border, with Austrian lots (H21, H41, H51, H53) governed by Austrian procurement law and Italian lots (H61, H71) governed by Italian public works regulations. Contractors working across both jurisdictions include Webuild, Implenia, STRABAG, and the Integra Consortium. Each operates under the contracting regime of its respective national section while exchanging geological data, TBM performance records, and alignment surveys with counterparts on the opposite side of the border.

The EU’s monitoring role, exercised through the CEF Transport programme and CINEA (the European Climate, Infrastructure and Environment Executive Agency), adds a third layer of reporting and compliance. The total EU contribution of €2.3 billion is subject to audit rights and milestone conditions that the project must meet on a defined schedule. This governance complexity has not slowed the project to a halt, which, given European infrastructure’s track record on large cross-border projects, is itself a significant achievement. The Brenner Base Tunnel SE model is increasingly cited by European Commission analysts as a replicable framework for future TEN-T cross-border projects.

Engineering Achievement 8: The Environmental Performance of an Alpine Mega-Project

The Brenner region is ecologically sensitive by any measure: protected river corridors, karst groundwater systems, Alpine wildlife habitats, and communities that have navigated the social costs of the existing motorway for decades. The Brenner Base Tunnel’s environmental performance is not incidental. It is a condition of the project’s political support in both countries and a requirement of EU funding eligibility under the TEN-T framework’s sustainability criteria.

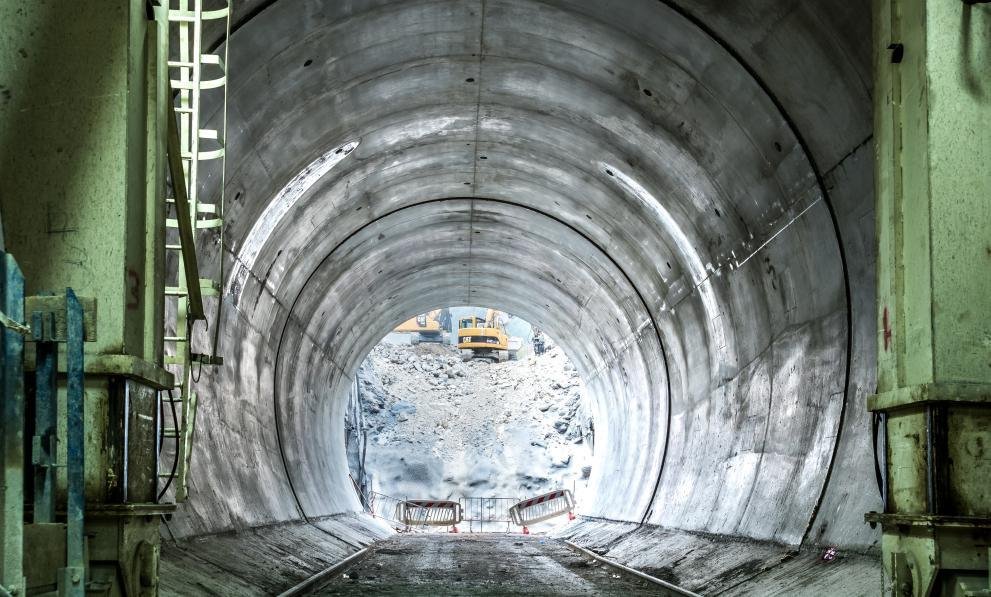

The Isarco section-lined tunnel.
The Isarco section-lined tunnel. (Source: CINEA)

Spoil Management, Noise Control, and the Modal Shift Environmental Dividend

The Brenner Base Tunnel generates approximately 14 million cubic metres of excavated material, the largest spoil volume of any current European tunnelling project. Austrian construction lots process inert tunnel spoil on-site for use as construction aggregate, reducing the volume requiring disposal and cutting the number of HGV trips through Innsbruck’s tunnel access roads. The Sill Gorge section, which runs through a recreational corridor used by Innsbruck residents, operates under strict noise controls, with defined work-hour windows and vibration-monitoring requirements.

The long-term environmental case for the Brenner Base Tunnel rests on the arithmetic of modal shift. The existing Brenner corridor carries approximately 14 percent of all Alpine road freight. Diverting a significant share of that traffic to electric rail removes diesel truck emissions from one of Europe’s most ecologically sensitive mountain passes. EU projections indicate the tunnel could reduce CO₂ emissions on the corridor by up to 66 per cent compared to the baseline road freight scenario.

It is worth contrasting this approach with the environmental engineering demands of the Strait of Messina Bridge, which faces a different set of ecological constraints above an active seismic zone. Both projects are reshaping European transport infrastructure, but the environmental mitigation strategies are almost entirely project-specific: what works under the Alps does not translate to a 3.3-kilometre suspension span over a seismically active strait.

Further Reading: Strait of Messina Bridge: 7 Remarkable Engineering Challenges Behind Italy’s Most Ambitious Megaproject

Engineering Achievement 9: Progress Milestones and the Path to 2032

The Brenner Base Tunnel has been under construction in various phases since 2007. The project’s trajectory through 2025 and 2026 shows a project in its final major excavation phase, with systems installation and fit-out becoming the dominant work front as the remaining tunnelling closes out.

From Breakthrough to Rail-Ready: The Final Phase

By August 2025, 88 per cent of the total Brenner Base Tunnel excavation was complete. The September 2025 exploratory tunnel breakthrough connected Austria and Italy underground for the first time in the project’s history, a milestone that EU Commissioner Tzitzikostas attended alongside the Italian and Austrian transport ministers. On the Austrian side, TBM Ida completed its 8,400-metre drive in August 2025, and TBM Olga was drilling a northward drive of more than 7.6 kilometres simultaneously on the Pfons-Brenner section as of early 2026.

Three construction lots remain active: two in Austria (H41 and H53) and one in Italy. The completed lots include Lot H52 Hochstegen, which finished in December 2023 after excavating 4.8 kilometres of exploratory tunnel, and Lot H71 Isarco River Underpass, also completed in December 2023. With all Italian excavation activities complete, the remaining work concentrates on the Austrian northern section and the full-project systems installation phase, covering track, electrification, signalling, safety systems, and tunnel fit-out across the 230-kilometre tunnel network.

The project remains on target for a 2032 opening. The cost has migrated from an original estimate of €8.5 billion to the current figure of €10.5 billion, a 24 per cent increase that reflects geological risks materialising in the fault zones, extended construction timelines on certain lots, and scope changes driven by updated safety standards. For context, this cost trajectory is comparable to the Gotthard Base Tunnel, which also exceeded its original budget, and to most European infrastructure megaprojects operating under comparable geological and regulatory conditions.

Conclusion: Brenner Base Tunnel and the Future of Alpine Infrastructure Engineering

The Brenner Base Tunnel represents far more than a new railway connection beneath the Alps. It demonstrates how modern infrastructure engineering can overcome some of the most difficult natural constraints on Earth through careful planning, advanced construction methods, and international cooperation. From the exploratory tunnel that transformed geology into actionable data to the specialised TBMs, deep-cover excavation strategies, and ground-freezing techniques beneath the Isarco River, every element of the project reflects a deliberate response to the challenges of building in an unpredictable Alpine environment. The scale of the tunnel, the complexity of its safety systems, and the coordination between Austria, Italy, contractors, and European institutions make it one of the defining infrastructure projects of the 21st century.

When the Brenner Base Tunnel opens, its greatest achievement may not simply be its record-breaking length or depth but its ability to reshape how Europe moves. By creating a flatter, faster, and more efficient rail route, the project aims to shift freight from roads to rail, reducing congestion, lowering emissions, and strengthening one of the continent’s most important transport corridors. The lessons from the Brenner Base Tunnel extend beyond the Alps: successful megaprojects depend not only on engineering innovation but also on geological understanding, governance discipline, environmental responsibility, and long-term strategic vision. As future infrastructure developments emerge across Africa and emerging markets, the Brenner Base Tunnel offers a valuable blueprint for delivering ambitious projects in complex environments.
